Projects 20 - ISCouncil

Rous Head Industrial Park

This project by Fremantle Ports has achieved an ‘Excellent’ As Built v1 IS Rating.

Overview

The project relates to the development of the reclamation area in Rous Head and comprises partitioning into lots, construction of the access roads, and the various services to the boundaries of the lots to allow subsequent tenants to develop business servicing the port.

“Some really simple changes put in place to address IS credits are having a significant impact on project sustainability outcomes and project team culture. For example, including an item for ‘Innovations/Opportunities’ in weekly project meetings has resulted in conversations about sustainability in practice, and many great ideas – particularly around material reuse – being implemented on site. Significant decisions about design, such as ‘best use’ of a public area, have been informed through scored assessment, community engagement and consultation with stakeholders. A key feature is to create a rookery habitat to attract a listed vulnerable bird species (the Australian Fairy Tern) in the hope that they will breed there early next year.”

Adam van der Beeke, Environmental Advisor, Fremantle Ports

Details

  • Rating Type Ports
  • Rating Score 54.4
  • Registered Date January 2012
  • Certification Date May 2017
  • Practical Completion January 2013
  • Jurisdiction Australia
  • States WA
  • Suburb Fremantle
  • Assessor Adam van der Beeke
  • Capital Value 15 Million
  • Other Stakeholders AECOMFremantle Ports, Brierty

Gold Coast Light Rail

This project by McConnell Dowell Constructors (Aust) Pty Ltd has achieved an ‘Excellent’ IS Rating.

Overview

The project relates to the development of a light rail system that passes through key activity centres of Southport, Surfers Paradise and Broadbeach. The 13-kilometre Stage One corridor and any future stages promise to significantly improve the liveability of the Gold Coast by improving accessibility, while reducing the effects of congestion that comes with a rapidly growing city. It is one of the most important pieces of transport infrastructure ever undertaken on the Gold Coast.

Details

  • Rating Type Rail
  • Rating Score 64.4
  • Registered Date June 2012
  • Practical Completion July 2014
  • Jurisdiction Australia
  • States QLD
  • Suburb Gold Coast
  • Assessor Anne Carleton
  • Capital Value $437 Million
  • Other Stakeholders Arup AustraliaCardnoMcConnell Dowell Constructors (Aust) Pty Ltd, GoldLinQ Consortium, Bombardier Transportation, KDR

Rating Highlights

Management Systems

Good scores on most credits.

Particularly good examples of knowledge sharing (toolbox talks, discussion forums, series of you-tube web episodes for use within the Australian Schools curriculum, including sustainability)

Full scores for risk and opportunity management, inspection and auditing, management system accreditation

Procurement and Purchasing

Level 2 achieved for all credits

  • Strong commitment to sustainable procurement
  • Consideration of sustainability during the identification and evaluation of suppliers

Suppliers sustainability performance is monitoring and managed throughout delivery of their contract
Water

The following water saving opportunities were implemented:

  • Water efficient devices in permanent and temporary facilities
  • Xeriscape landscaping
  • Collection of rainfall from depot roof
  • Recycled water in the wash-plant
  • Stormwater harvesting – i.e. rainwater tanks on crib huts
  • Sourcing non-potable water for dust suppression and compaction activities

Materials

Level 3 achieved for Mat-1

  • 55% improvement in embodied carbon based on a reference design
  • 104,000 tCO2e reduced through embodied carbon reductions

A significant reduction in materials lifecycle was achieved through design development phase and modified construction practices. Examples include:

  • Significant design changes
  • Reuse of materials on-site
  • Reduction in slab thickness for the track.
  • The use of exchangeable switch blades and track curves, which limits the amount of excavation and replacement concrete required
  • Relining pipes which are of sufficient capacity for future demands
  • Use of direction drilling/pipe jacking and other less intrusive methods of installing pipes – more than 2.5km completed without need to large excavations.

Discharges to Air, Land & Water

Level 3 achieved for all credits

No major exceedances of water quality, noise, vibration or air quality monitoring goals.

Land

>75% of the land used for the project is previously disturbed.

The project footprint is primarily within an existing road corridor, and as such 87% of the project land has been assessed as previously disturbed.

Mapping confirmed that the total construction footprint was 647,353m2, of which 81,889m2 was classified s undisturbed.

Waste

Achieved very high diversion rates from landfill, including,

  • all spoil from the project is either reused on site or is trucked offsite to a recycling site for reuse or reprocessing. Achieved a 100% recycling rate.
  • The project achieved a recycling rate of 89.7% across the board for inert and non hazardous wastes.

Community Health, Well-being and Safety

The project set a stretch target of recruiting 82.5% of project personnel from the extended Gold Coast area (including Scenic Rim, Brisbane City, Redlands, Logan and Ipswich). The project also set a target of providing 188,000 hours of deemed training to green labour and upskilling of local workforce. This target included providing 50 traineeships, apprenticeships and or cadetships (see Hea-1be).

Regular surveys confirm that over 96% of project employees were recruited from within the extended Gold Coast Area, with over 80% living within the Gold Coast City Council area.
Innovation

QLD first initiative to install a new track switching system that makes the process easier and allows for reduced time, cost and distruption during maintenance on the track switches. Using this system, the switch blade can be replaced from the top of rail, therefore there is no need to dig up the embedded concrete around the track switch to replace wearing parts.

Elizabeth Quay

This project by Metropolitan Redevelopment Authority (MRA) achieved a ‘Commended’ As Built v1.0 IS Rating.

Elizabeth Quay will cover nearly 10 hectares of prime riverfront land in the heart of the city. The project will create a magnificent precinct featuring a 2.7 hectare inlet surrounded by a split level promenade, shops, cafes, restaurants and other exciting entertainment venues.

‘One of the MRA’s key redevelopment goals is to enhance environmental integrity by encouraging ecologically sustainable design, resource efficiency, recycling, renewable energy and protection of the local ecology. Elizabeth Quay is no exception and the IS rating tool will provide an independent assessment of the project’s achievements against sustainability credits.’

Metropolitan Redevelopment Authority

Details

  • Rating Type Social
  • Rating Score 31.7
  • Registered Date November 2013
  • Certification Date March 2018
  • Jurisdiction Australia
  • States WA
  • Suburb Perth
  • Assessor Feigh Sugg
  • Capital Value $456 Million
  • Other Stakeholders Arup AustraliaCPB Contractors Pty Limited, Broad, ARM, Wood and Grieve,

Website

For more information about this project, visit the MRA website.

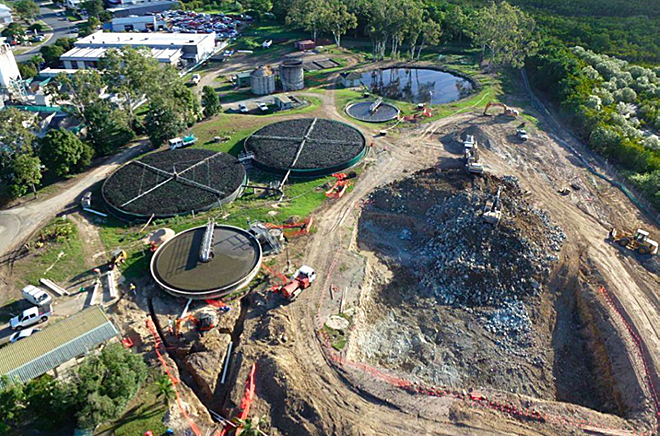

Whitsunday WWTP

Overview

Two sewage treatment plants – at Proserpine and Cannonvale in North Queensland – are being upgraded to serve growing communities and meet the most stringent effluent discharge requirements to protect the Great Barrier Reef. They will also provide benefits to the local community by reducing sewage overflows, and improving noise and odour.

Carbon saved over infrastructure lifecycle (tCO2e)    20,510
Water saved over infrastructure lifecycle (ML)    2,966
Materials lifecycle impact reduction (Ecopoints)    5,578
Materials lifecycle impact reduction (tCO2e) 3,149

Details

  • Rating Type Water
  • Rating Score 56.4
  • Registered Date March 2014
  • Practical Completion May 2014
  • Jurisdiction Australia
  • States QLD
  • Suburb Whitsundays
  • Assessor Matthew Brennan
  • Capital Value $45 Million
  • Other Stakeholders Downer, Whitsunday Regional Council

Rating Highlights

  • Management Systems Good management systems integrating the IS rating tool into practices. Knowledge sharing clearly demonstrated with a number of internal and external events/initiatives undertaken to share sustainability lessons learnt.
  • Procurement and Purchasing Pro-1 Level 3. Strong commitment to and application of sustainable procurement including local procurement:
    •  61% of total spend in the Whitsunday region
    • 30% of total spend in greater Queensland
  • Climate Change Adaptation Cli-1 Level 2, Cli-2 Level 3. The project undertook a thorough, formal climate change risk assessment and implemented controls to reduce 22 ‘high’ or ‘very high’ risks to a ‘moderate’ or ‘low’ rating.
  • Energy and Carbon Ene-1, Ene-2 Level 2. 20,700 tCO2e reduced through the implementation of carbon and energy reduction strategies over the life of the asset. This equates to a 15.5% reduction in energy use.
  • Water Wat-1, Wat-2 Level 2. 43% total lifecycle water saving for the Tenix Design over the Base Case Design. This represents a volume saving of approximately 3 GL. This saving is almost entirely due to more efficient use of recycled effluent.
  • Materials Mat-1 Level 2. 3,149 tCO2e saved through optimised design and use of recycled aggregates. Reduction in 4200 tonnes of concrete
  • Discharges to Air, Land & Water During construction the project did not receive any noise, vibration or dust complaints. Vibration causing activity was only conducted during normal weekday hours to minimise impacts on residential receivers
  • Ecology Eco-2 Level 2, Eco-3 Level 3. Ecological value enhanced through >5,000m2 of regenerated native habitat and 1,000m2 of wetland. Biodiversity Values have been improved by more than 200% at both sites, and, even allowing for significant attrition within the revegetation plots, an overall enhancement to the site for more than 20% is achievable within a 30 year period.
  • Community Health, Well-being and Safety Hea-1, Hea-2 Level 2. The following two key priority community health and wellbeing indicators have been established, implemented and monitored for the project
    • quality of water discharged from wastewater treatment plants is of critical importance
    • support economic development and employment

    The results of the monitoring demonstrated that there had been an improvement over time i.e. local participation increased from 59% at the time of submitting for the Design Rating to 61% at the completion of construction and the water quality of receiving waters has improved significantly with the completion of both plants.

  • Innovation Inn-1 Level 3. Tenix has developed Parallel Nitrification and De Nitrification (PND) technology for the Proserpine Plant.Patents have been granted for the PND technology in Australia, USA, Singapore and NZ. Compared to BAU technologies, this world first process:
    • Significantly improves nitrogen removal
    • Is more compact
    • Uses less construction materials
    • Is more energy efficient

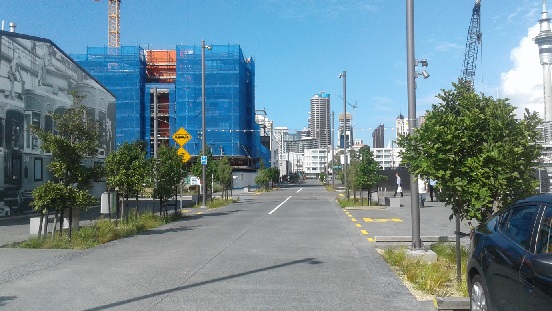

Madden and Pakenham St Road Upgrade

This project by Panuku Development Auckland achieved an ‘Excellent’ Design v1.0 IS Rating.

Overview

This project is located within Auckland’s newest waterfront area and urban community, Wynyard Quarter. The project includes a road upgrade of existing Madden Street and Pakenham Street West to support improved stormwater management, future development and street life.

“We registered this project to demonstrate via a 3rd party verified tool that Development Auckland is committed to meeting the environmental, social and cultural objectives of our Waterfront Plan and Sustainable Development Framework. The major benefit to our project through implementing the IS scheme is it will focus our work practices to deliver better auditing and reporting on a quadruple bottom line standing. It also allows us to communicate to the community that Development Auckland is committed to sustainability in the infrastructure we deliver and are happy to have this rated by an independent body.”

– Ralph Webster, Design Manager, Development Auckland

Details

  • Rating Type Road
  • Rating Score 57
  • Registered Date February 2014
  • Certification Date October 2015
  • Practical Completion October 2016
  • Jurisdiction New Zealand
  • States NZ
  • Suburb Auckland
  • Capital Value $13 Million
  • Other Stakeholders Downer

City Rail Link – Enabling Works Contract 1

Rating Highlights:

Management systems

  • Well defined and integrated sustainability management system
  • CRL communications framework outlines a requirement for an annual sustainability report which will detail performance on the Infrastructure Sustainability Rating, zero waste to landfill, engagement with Mana Whenua, calculating a carbon footprint and materials monitoring. This will be distributed to the public during August 2016.
  • Sustainability reporting and management will be reviewed by the Community Liaison Group.
  • The CRL Infrastructure Sustainability Management Plan and Sustainability Communications Framework includes provisions for sharing sustainability knowledge within the project team, wider AT, external stakeholders and general public, initiatives include; internal knowledge sharing database, public website on sustainability aspects, CRL sustainability forums, conference papers and presentations.
  • Decision making guidelines have been developed for the project. These guidelines align with the Man-8 credit criteria and clearly demonstrate an intention to consistently apply sustainability throughout decision making across the whole CRL project.

Climate Change

Level 2 verified for Climate change risk and adaptation.

A comprehensive risk assessment process was completed for the broader City Rail Link project. Specific adaptation measures have been identified at a package level and have been implemented through the design process:

  • Damage to track equipment from saltwater: design altered to accommodate
  • People fainting in trains / at stations as a result of increased temperatures. Currently natural ventilation with some forced fresh air (e.g. piston effect of trains). Future proofing for passenger screen doors (PSDs) cooling and ventilation -space provision for required plant and ducts as well as electrical capacity. Currently natural ventilation with some forced fresh air (e.g. piston effect of trains pushing in air at K-Rd). Future proofing for passenger screen doors (PSDs) cooling and ventilation -space provision

Energy

Level 3 verified for Energy and Carbon reduction

The modelling shows a reduction in Scope 1 and Scope 2 emissions by 25.73% over the infrastructure’s life-cycle, with no emissions from land clearing. The initiatives that are predicted to reduce emissions are (in order of importance):

  • Station plant efficiency
  • Removal of radiant heating in the station
  • Energy saving modes added to the escalators
  • Motion and daylight sensors for the station lighting
  • Switching from diesel generators to grid electricity during construction
  • Changes to piling methodology
  • The use ofbio-diesel

The modelling includes significant Scope 3 emissions as laid out in the methodology section of the report. The most significant source is electricity line losses, mostly during operation, but also during construction. There are also scope 3 emissions expected from the haulage of waste from site. The modelling shows the reduction in Scope 3 emissions is predicted to be 24.65%, resulting in an overall reduction for Scope 1-3 during delivery and operation of 15,082 tCO2e, equating to a 25.64% decrease in GHG emission

Water

All significant water uses were modelled, and an audit was undertaken of the existing water use at the station

The water use report shows that the initiatives planned will result in a 52.6% reduction in water use over the lifecycle of the asset, with a 19.8% reduction achieved during construction, and 52.9% during operation.

During construction the largest savings are projected to come from the changes in construction methodology that requires less jet grouting, reducing the projected water used for this by 41%. Smaller, but still useful savings are projected to come from changes in piling (27% reduction), the bentonite plant (19%), and the reduction in wheel washing (11%) that results from fewer materials needing to be transported to and from site due to the changed piling methodology.

For operation, the opportunity to improve the efficiency of the (very busy) public toilets in the station is expected to provide the greatest savings, with a 64% reduction from the existing toilets, which an audit found are operating well outside their specification. Although the greatest absolute savings are expected to be achieved through the replacement of the public flush toilets, which the audit found were using almost 12 litres of water per flush, the largest projected relative savings, at 81%, come from the upgrade of the urinals. The new urinal specification is expected to deliver these savings because, being WELS 6 rated urinals, they use less water per flush (0.8L vs 2.4L, a 66% saving) and they use motion sensors, so are expected to flush less often compared to the existing urinals which flush every two minutes. It should be noted that usage, which affects the percentage saving attributable to the motion sensors, is estimated based on observed usage (peak and off-peak during the audit), and so has less certainty than the saving resulting from the reduction in water use per flush. We nonetheless believe it to be a reasonable estimate, and being only 8% of the total water used, any inaccuracies in this assumption will not have a material impact on the overall saving. The staff facilities provide a more moderate saving at 17%, whilst no saving is projected for the retail areas (whose water use is outside the control of the station managers), or for the urban realm tree watering and cleaning.

Discharges to Air Land and Water

Level 3 verified for Water Quality, Noise, Vibration and Air Quality credits.

This will be confirmed throughout construction.

Waste Management

Full score verified for Was-1 Waste Management

The project has a target of zero waste to landfill.

Stakeholder Engagement

Full points achieved for Sta-2 Level of Engagement

The criterion was met by consulting with stakeholders via open days, newsletters, CRL Design Roadshows (13 suburbs through Auckland), one-on-one meetings, presentations and the website as per the Construction Communication Consultation Plan (CCCP). Specific negotiable and non-negotiable issues are highlighted on the website and during open days.

The criterion was met by involving the local community in the design of the environmental management plans. Draft plans were written and provided to a community liaison group (CLG) to review as residents and businesses in the area. All comments from the community were reviewed and either used to amend the plan or provided with a reason why they were not included in the plans. Negotiable and non-negotiable issues were explained during the CLG meetings.

The criterion was met by collaborating with Mana Whenua (Māori who have tribal links to Auckland). Working with Mana Whenua makes the CRL a unique project by incorporating culture and history in station designs and public space.

Innovation

World First Innovation: Embedding cultural values within a sustainability rating framework.

This initiative and the inclusion of cultural values has been crossed checked with other international rating schemes. It has been confirmed that this is a first.

The work undertaken, collaborating with Mana Whenua to embed Māori cultural values across the IS framework includes the following outcomes:

  • has transformed a select number of IS credits to address the cultural values of Mana Whenua,
  • are raising the knowledge base of our client team and contractors and
  • are responding to the cultural values of Mana Whenua in the delivery of CRL. 

Gold Coast Light Rail – Stage 1

This project by McConnell Dowell Constructors (Aust) Pty Ltd has achieved an ‘Excellent’ IS Rating.

Overview

The project relates to the development of a light rail system that passes through key activity centres of Southport, Surfers Paradise and Broadbeach. The 13-kilometre Stage One corridor and any future stages promise to significantly improve the liveability of the Gold Coast by improving accessibility, while reducing the effects of congestion that comes with a rapidly growing city. It is one of the most important pieces of transport infrastructure ever undertaken on the Gold Coast.

Details

  • Rating Type Rail
  • Rating Score 64.4
  • Registered Date June 2012
  • Practical Completion July 2014
  • Jurisdiction Australia
  • States QLD
  • Suburb Gold Coast
  • Assessor Anne Carleton
  • Capital Value $437 Million
  • Other Stakeholders Arup AustraliaCardnoMcConnell Dowell Constructors (Aust) Pty Ltd, GoldLinQ Consortium, Bombardier Transportation, KDR

Rating Highlights

Management Systems

Good scores on most credits.

Particularly good examples of knowledge sharing (toolbox talks, discussion forums, series of you-tube web episodes for use within the Australian Schools curriculum, including sustainability)

Full scores for risk and opportunity management, inspection and auditing, management system accreditation

Procurement and Purchasing

Level 2 achieved for all credits

  • Strong commitment to sustainable procurement
  • Consideration of sustainability during the identification and evaluation of suppliers

Suppliers sustainability performance is monitoring and managed throughout delivery of their contract
Water

The following water saving opportunities were implemented:

  • Water efficient devices in permanent and temporary facilities
  • Xeriscape landscaping
  • Collection of rainfall from depot roof
  • Recycled water in the wash-plant
  • Stormwater harvesting – i.e. rainwater tanks on crib huts
  • Sourcing non-potable water for dust suppression and compaction activities

Materials

Level 3 achieved for Mat-1

  • 55% improvement in embodied carbon based on a reference design
  • 104,000 tCO2e reduced through embodied carbon reductions

A significant reduction in materials lifecycle was achieved through design development phase and modified construction practices. Examples include:

  • Significant design changes
  • Reuse of materials on-site
  • Reduction in slab thickness for the track.
  • The use of exchangeable switch blades and track curves, which limits the amount of excavation and replacement concrete required
  • Relining pipes which are of sufficient capacity for future demands
  • Use of direction drilling/pipe jacking and other less intrusive methods of installing pipes – more than 2.5km completed without need to large excavations.

Discharges to Air, Land & Water

Level 3 achieved for all credits

No major exceedances of water quality, noise, vibration or air quality monitoring goals.

Land

>75% of the land used for the project is previously disturbed.

The project footprint is primarily within an existing road corridor, and as such 87% of the project land has been assessed as previously disturbed.

Mapping confirmed that the total construction footprint was 647,353m2, of which 81,889m2 was classified s undisturbed.

Waste

Achieved very high diversion rates from landfill, including,

  • all spoil from the project is either reused on site or is trucked offsite to a recycling site for reuse or reprocessing. Achieved a 100% recycling rate.
  • The project achieved a recycling rate of 89.7% across the board for inert and non hazardous wastes.

Community Health, Well-being and Safety

The project set a stretch target of recruiting 82.5% of project personnel from the extended Gold Coast area (including Scenic Rim, Brisbane City, Redlands, Logan and Ipswich). The project also set a target of providing 188,000 hours of deemed training to green labour and upskilling of local workforce. This target included providing 50 traineeships, apprenticeships and or cadetships (see Hea-1be).

Regular surveys confirm that over 96% of project employees were recruited from within the extended Gold Coast Area, with over 80% living within the Gold Coast City Council area.
Innovation

QLD first initiative to install a new track switching system that makes the process easier and allows for reduced time, cost and distruption during maintenance on the track switches. Using this system, the switch blade can be replaced from the top of rail, therefore there is no need to dig up the embedded concrete around the track switch to replace wearing parts.

ACT Basin Priority Project

This project by ACT Government – Environment Planning and Sustainable Development.

Overview

The ACT is at the top of the Murray Darling Basin, making the treatment of storm water important to water flowing into the Murrumbidgee river and down-stream through NSW, Victoria and South Australia. Storm water treatment involves reducing organic nutrients that arise from low-to-medium flow from rain fall events, by slowing down and filtering sediment. This is best achieved through a distributed water quality options that can treat complex water-flows from around the catchment.

Six catchments were identified for prioritisation of water quality options across the ACT. On 4 December, the ACT Government’s Environment and Planning Directorate submitted a business case to the Commonwealth for funding, under an inter-jurisdictional agreement on water management, to design and construct priority projects to improve storm-water quality across the six catchments. The Commonwealth has indicated informally that the business case will meet due diligence requirements, and that funding will be approved for CAPEX (design and construction) of about $80m.

Although the total CAPEX may not be large by comparison, for example, to major transport infrastructure projects, the program of projects is made complex by the number and different types of projects to be implemented. The water quality projects include construction of wetlands and bio-retention systems, and other water quality options. This is to be achieved within a short time frame and few growing seasons to establish vegetation. It is anticipated that there will be 25 projects in all, 6 consultants, and the program of projects managed centrally by the Environment and Planning Directorate, for completion by mid-2019. Early project design in underway.

Details

  • Rating Type Water
  • Registered Date June 2016
  • Jurisdiction Australia
  • States ACT
  • Suburb Canberra
  • Assessor Kai Anderson
  • Capital Value $50 Million

Website

To find out more about this project, visit the ACT Government website.
